re roofing listed buildings
N NEAL ROOFING Heritage Roofing · Leadwork · Conservation
Grade II* Listed Building / North Yorkshire

Re-Roofing a Grade II* Listed Building

A major heritage-roofing project involving Westmorland slate, Code 5 lead gutters, concealed drainage, insulation improvements, bat mitigation and traditional detailing.

Building StatusGrade II* Listed
LocationNorth Yorkshire
Primary CoveringWestmorland Slate
Lead SpecificationCode 5 Rolled Lead Sheet
Project Overview

Specialist Re-Roofing for a Historic Property

Re-roofing a Grade II* listed building requires conservation-led planning, specialist workmanship and close coordination between roofing, leadwork, drainage, insulation and ecology requirements.

This project combined traditional Westmorland slate and rolled lead sheet with modern insulation, concealed drainage improvements and carefully planned bat mitigation.

A detailed specification and method statement were central to defining materials, responsibilities, sequencing, retained fabric and hidden-defect procedures.

Conservation Approach

Existing materials were retained and reused wherever they remained serviceable, with reclaimed matching material introduced only where shortages occurred.

01
Project Film

Watch the Project Before, During and After

The original project video is retained below and provides a visual overview of the listed-building roofing work.

02
Historic Context

History of the Property

Built around 1770 by Leonard Smelt, the property occupies a prominent position above the River Swale in North Yorkshire.

The building is surrounded by parkland, agricultural land and floodplain, with long-distance views toward the Cleveland Hills, Nidderdale, the North Pennines and the Lake District.

The property was remodelled extensively during the mid-nineteenth century and reduced in size during the 1960s.

01

Westmorland Slate

The roof was covered in diminishing courses of traditional Westmorland slate.

02

Concealed Lead Gutters

Perimeter gutters sat behind a brick parapet with stone copings.

03

Internal Drainage

The roof discharged inward to concealed tanks rather than external downpipes.

04

Historic Alterations

The roof and drainage arrangement reflected nineteenth- and twentieth-century changes.

05

Prominent Setting

The building’s elevated setting increased the importance of material and visual compatibility.

06

Conservation Significance

Every intervention had to respect the building’s architectural and historic value.

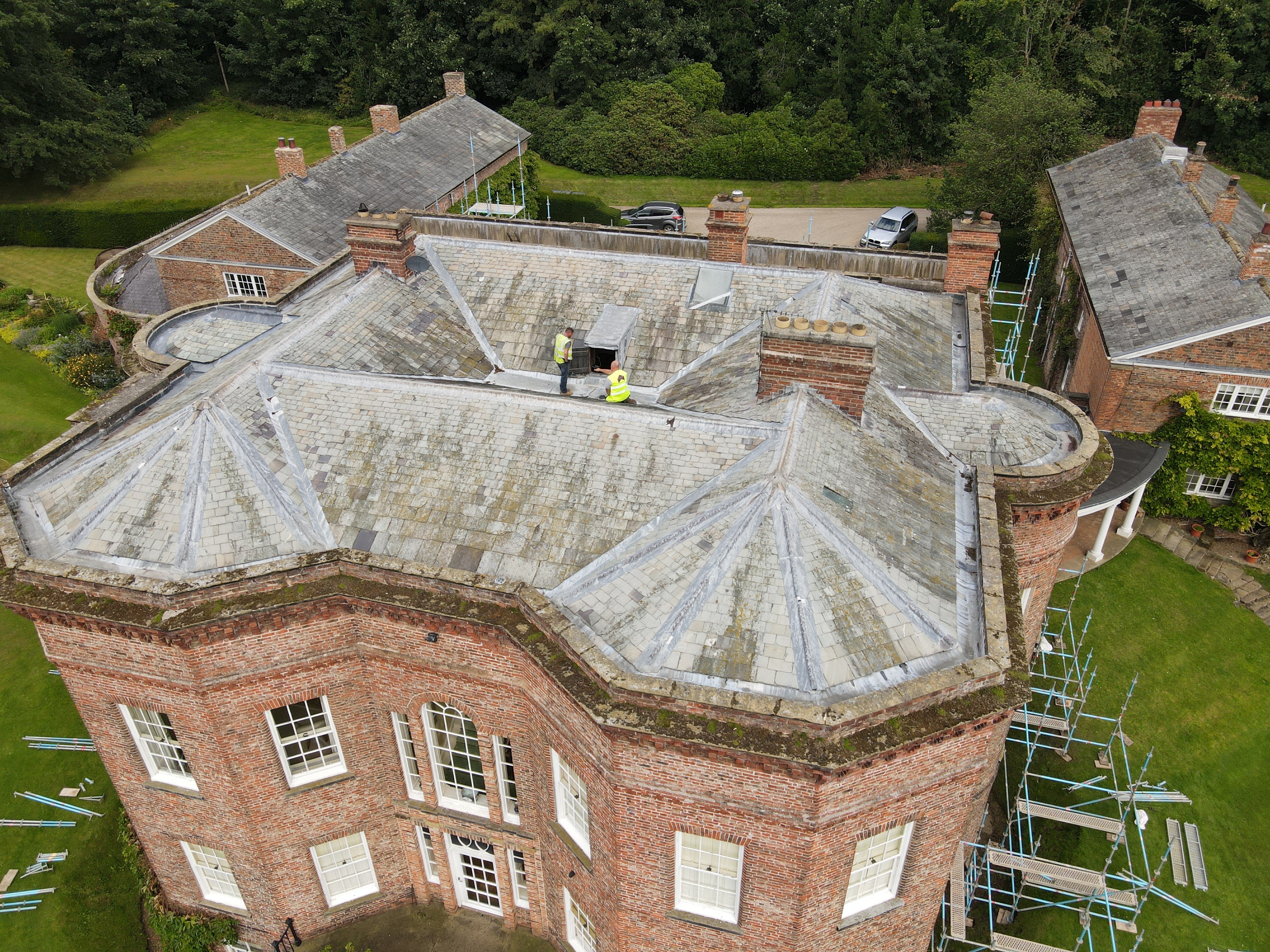

Grade II star listed building roofing project in North Yorkshire
03
Traditional Roofing Scheme

The Agreed Scope of Work

01

Slate Removal and Reuse

Carefully remove and reinstate existing Westmorland slate, supplementing shortages with reclaimed matching material.

02

Lead Gutter Renewal

Replace timber substrates and install new Code 5 lead linings to concealed perimeter gutters.

03

Insulation Upgrade

Improve thermal performance while respecting the existing roof form and applicable requirements.

04

Chimney Flashings

Renew lead flashings to chimney stacks and associated roof interfaces.

05

Glazed Roof Panels

Install new glazed panels with lead perimeter details in selected locations.

06

Bat Mitigation

Include measures to protect bats and maintain suitable access points.

04
Leadwork and Water Management

Concealed Drainage and Traditional Lead Details

01

Purpose-Made Holding Tanks

Modern underground drainage components were incorporated into new internal holding tanks.

02

Concealed Downpipes

Water was redirected through two concealed fall pipes behind the later façade.

03

Lead Overflow Details

Code 5 lead overflows were included as an early-warning measure for future blockages.

04

Lead Hips and Ridges

Timber king rolls and stainless-steel clips secured renewed hip and ridge details.

05

Stepped Lead Gutters

The parapet arrangement was used to create suitable falls and steps within the lead-lined gutters.

06

Managed Tank Removal

Five large galvanised tanks were removed from the loft using a fully managed crane lift.

Why Concealed Drainage Needs Care

Because concealed systems can hide developing defects, reliable falls, overflow routes, accessible maintenance points and inspection procedures are especially important.

06
Project Progress

Work Completed at the Time of the Original Update

01

Lead-Lined Gutters

The new gutters and associated joinery had been installed.

02

Roofing Membrane

The roof had been covered and bat-mitigation measures incorporated.

03

Loft Insulation

The loft had been cleaned and fully insulated.

04

Internal Drainage

The concealed drainage system had been installed and tested.

05

Structural Coordination

Joinery, leadwork and drainage details were coordinated before slate reinstatement.

06

Conservation Records

Progress was documented to support project control and heritage decision-making.

Roofing work progressing on a listed building in North Yorkshire
People Also Ask

Listed-Building Roofing FAQs

Can a Grade II* listed building be re-roofed?

Yes, but the proposed changes, materials and methods should be agreed through the appropriate conservation and consent process.

What is the difference between Grade II and Grade II*?

Grade II* buildings are particularly important and of more than special interest, so proposed roofing changes may require especially careful justification and documentation.

Can original Westmorland slate be reused?

Sound slate can often be retained and reused after careful stripping, sorting and assessment, with compatible reclaimed slate used for shortages.

Why use Code 5 lead on heritage roofs?

Code 5 rolled lead sheet can suit gutters, valleys and other details where the design, sheet sizes, substrate and movement allowance are appropriate.

Do listed-building roof repairs need consent?

Work affecting the building’s special architectural or historic interest may require listed-building consent. The position should be confirmed before work begins.

Can insulation be added to a historic roof?

Often, yes, but the thermal and moisture design must respect the existing building fabric and avoid creating condensation or trapping moisture.

What happens if bats are found?

Work may need to pause while ecological advice, licensing and mitigation requirements are confirmed.

Why are concealed gutters higher risk?

They can hide blockages and leaks, making reliable falls, overflows, inspection access and maintenance especially important.

How long does a heritage reroof take?

Duration depends on roof size, access, weather, consent conditions, material salvage, ecology, leadwork and hidden defects.

What should I look for in a heritage roofing contractor?

Look for comparable project evidence, specialist slate and leadwork skills, clear documentation, suitable insurance and understanding of conservation-led repair.

Heritage Roofing Yorkshire

Discuss a Listed-Building Roofing Project

Neal Roofing can support surveys, Westmorland slate, rolled lead sheet, concealed drainage, chimneys, insulation and coordinated conservation roofing projects.
